KUSUM Scheme

PM KUSUM Scheme Is Lagging Behind…

The Indian government introduced a nationwide plan for farmers in 2019 with the goal of enhancing energy security and de-dieselizing the agricultural sector. Pradhan Mantri Kisan Urja Suraksha Evam Utthaan Mahabhiyaan (PM-KUSUM) is the name of the scheme.

KUSUM

The KUSUM aims to install 30.8 GW of solar electricity for agriculture by 2022, which will be accomplished by three plan components –

  • Component A: To build 10 GW of solar capacity by installing tiny solar power plants with capacities of up to 2 MW.
  • Component B: Installation of 20 lakh solar-powered farm pumps on their own.
  • Component C: To solarize 15 lakh current grid-connected agricultural pumps.

So far, the performance of the KUSUM plan has been disappointing across all three components.

Component B, on the other hand, has made more progress than components A and C. As of April 2022, the central government has sanctioned around 3.6 lakh standalone solar powered pumps under component B.

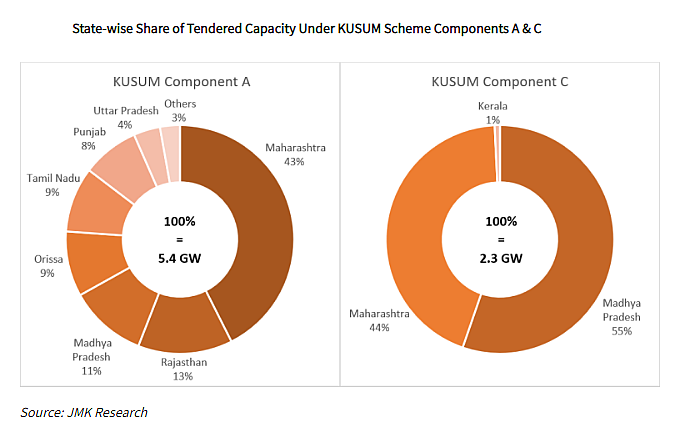

As of June 2022, a total of 25 bids (Component A – 19, Component C – 6) have been launched under components A and C. (i.e., in the past 32 months since November 2019). From November 2019 to June 2022, only 7.7 GW worth of bids were published throughout KUSUM components A and C.

The International Energy Agency (IEA) anticipated in December 2021 that India will fall short of its KUSUM objective, with just around one-third of the 30.8 GW target completed between 2021 and 2026. The IEA attributed the gap to the scheme’s “funding and implementation issues.”

Given that the central government established a target of 100 percent de-dieselization of the farm sector by 2024, it is all the more crucial to overcome such significant problems and revitalize the KUSUM program.
